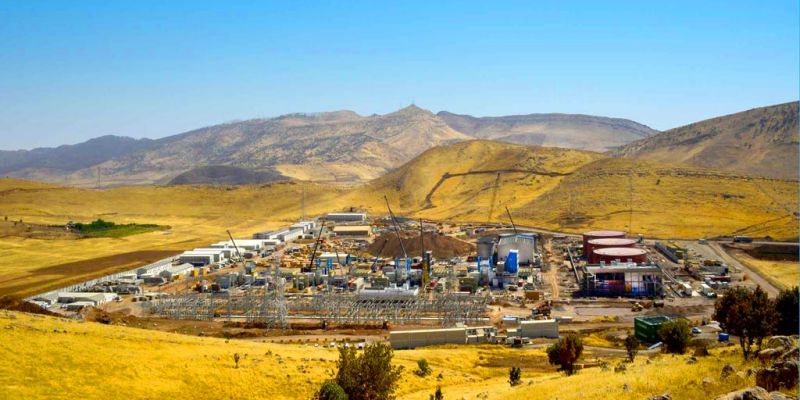

ENKA is getting closer to project close-out on Bazian Simple Cycle Power Plant Project in Northern Iraq. As of October 2015, engineering, procurement, manufacturing and T&L works have been almost completed. Construction works progress is 95% and commissioning works are ongoing. Fuel oil which will be used for “Light Distillate” commissioning works and the Gas Turbine’s First Fire as well, was received to “Untreated Tank”. Planned first fire date is 15 November 2015. 6,6 kV Switchgears, Common MCC & Load-Center, Batteries, DC-UPS, 132 kV Switchyard, DCS, Diesel MCC and PEECC MCC & Mark VI, systems were all energized with temporary power and ready for the first fire. Class room trainings for the operation and maintenance personnel were scheduled with vendors and will commence soon.
