TAIF Business Center Project Progress as of December 2019

The TAIF Business Centre Project, being undertaken in Kazan, the capital of Tatarstan, reached the overall progress of 85.5% as of the end of 2019, having achieved 3,788,512 person-hours  without Lost Time Incident (LTI) with 760 workers  currently employed at the project. The progress of architectural works amounts to 82% with 17,595 m2 of the …

Nizhnekamsk 495 MW CCPP Progress

Commodities purchasing is 60% complete and 2x gas turbines with uxiliaries, steam turbine with auxiliaries, condenser, 3 x Generators, 2 x HRSGs with auxiliaries and 3 x GSU transformers delivered to site. The major site accomplishments of project include 2 x Gas Turbine, 1 x Steam Turbine, 3 x Generators, Condenser and 3 x Step …

Cimtas Precision Machining has extended its Nadcap Certification for Shot Peening until April 2021

Cimtas Precision Machining has extended its National Aerospace and Defense Contractors Accreditation Program (Nadcap) certification for Shot Peening until April 2021. The original approval had been acquired in February 2019. Cimtas Precision Machining passed the second shot peening audit with zero findings, just like the original audit earlier in 2019. Shot Peening is a special …

Cimtas Pipe Longitudinal Submerged Arc Welded (“LSAW”) Pipe Works won 5-Star Rating for Health and Safety Management System from BSC

BSC is a not-for-profit organization founded in 1957, promoting excellence in health, safety and environmental management services in more than 60 countries around the world. The 5-Star Audit carried out by BSC is one of the most comprehensive, contemporary, quantified audit process available globally, which tests companies’ health, safety and environmental management system performance against …

750 MW Samawa CCPP project, the early first fire of GTG Unit no 1 has been successfully completed

We are pleased to announce that ENKA, with its business partner GE, has achieved one of the critical milestones at 750 MW Samawa CCPP project, located in Iraq. Accordingly, the early first fire of GTG Unit no 1 has been successfully completed by the project team on December 25th, 2019.

750 MW Dhi Qar CCPP project, the early first fire of GTG Unit no 1 has been successfully completed.

We are pleased to announce that ENKA, with its business partner GE, has achieved one of the critical milestones at 750 MW Dhi Qar CCPP project, located in Basrah, Iraq. Accordingly, the early first fire of GTG Unit no 1 has been successfully completed by the project team on December 24th, 2019.

Samawa 750 MW Power Plant reached 3,000,000 Person-Hours without LTI as of December 21, 2019!

We are pleased to announce that that Samawa 750 MW Combined Cycle Power Plant Project in Iraq, which we are executing in consortium with GE, reached 3,000,000 person-hours without lost time incident as of December 21, 2019! We would like to thank all team members who contributed to achieving such milestone, we hope this success …

The progress of 3GP MEI Installation works in Tengiz as of December 2019

By the mid of December 2019, the completion progress of 3GP Mechanical, Electrical and Instrumentation Installation works in Tengiz, Kazakhstan reached 19% and the number of employees working on the project site achieved 2,400 and 3 million person-hours had been worked without lost time incident (LTI). The major site accomplishments of the project include the …

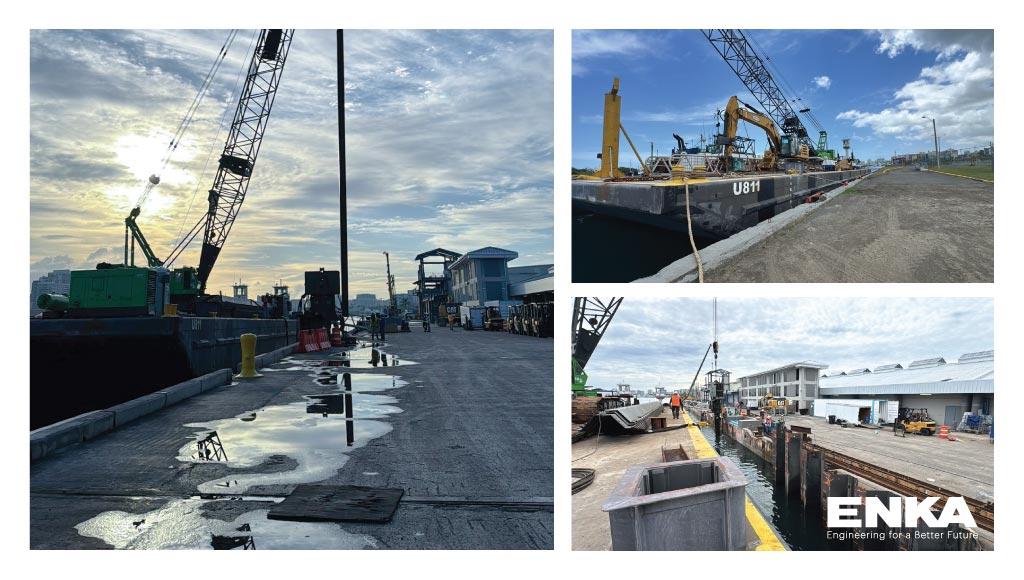

Çimtaş completed manufacturing of Shaft, Tower Anchor Block and Tower Panel for 1915 Çanakkale Bridge

Çimtaş, a fully owned subsidiary of ENKA, manufacturing the permanent steel structures of the 1915 Çanakkale Bridge with a total weight exceeding 100,000 ton, has completed Shaft, Tower Anchor Block and Tower Panel manufacturing until today. While Tower Blocks continue to rise in Çanakkale; Tower Block Formation and shipments are going on at full speed …
